References

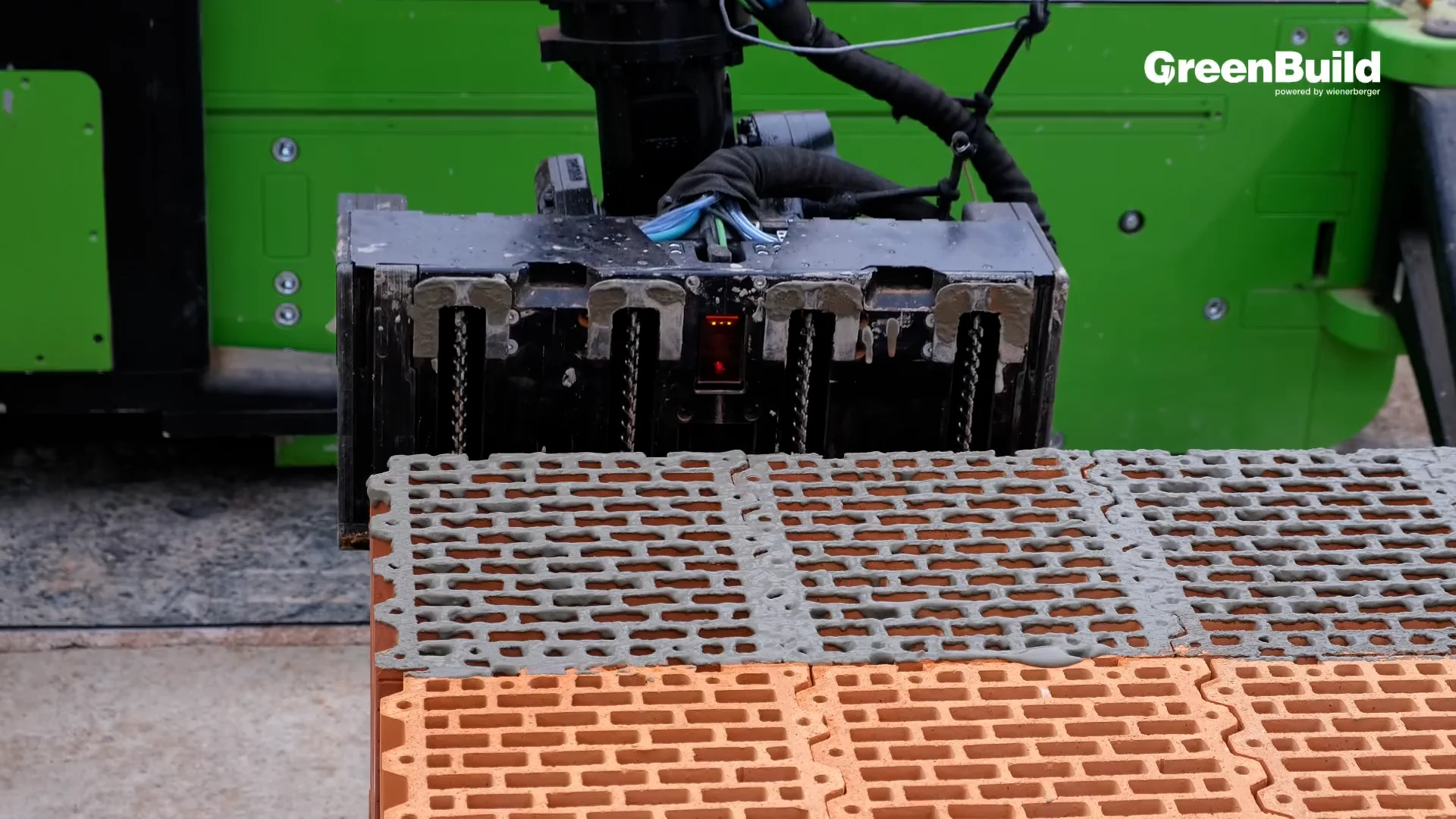

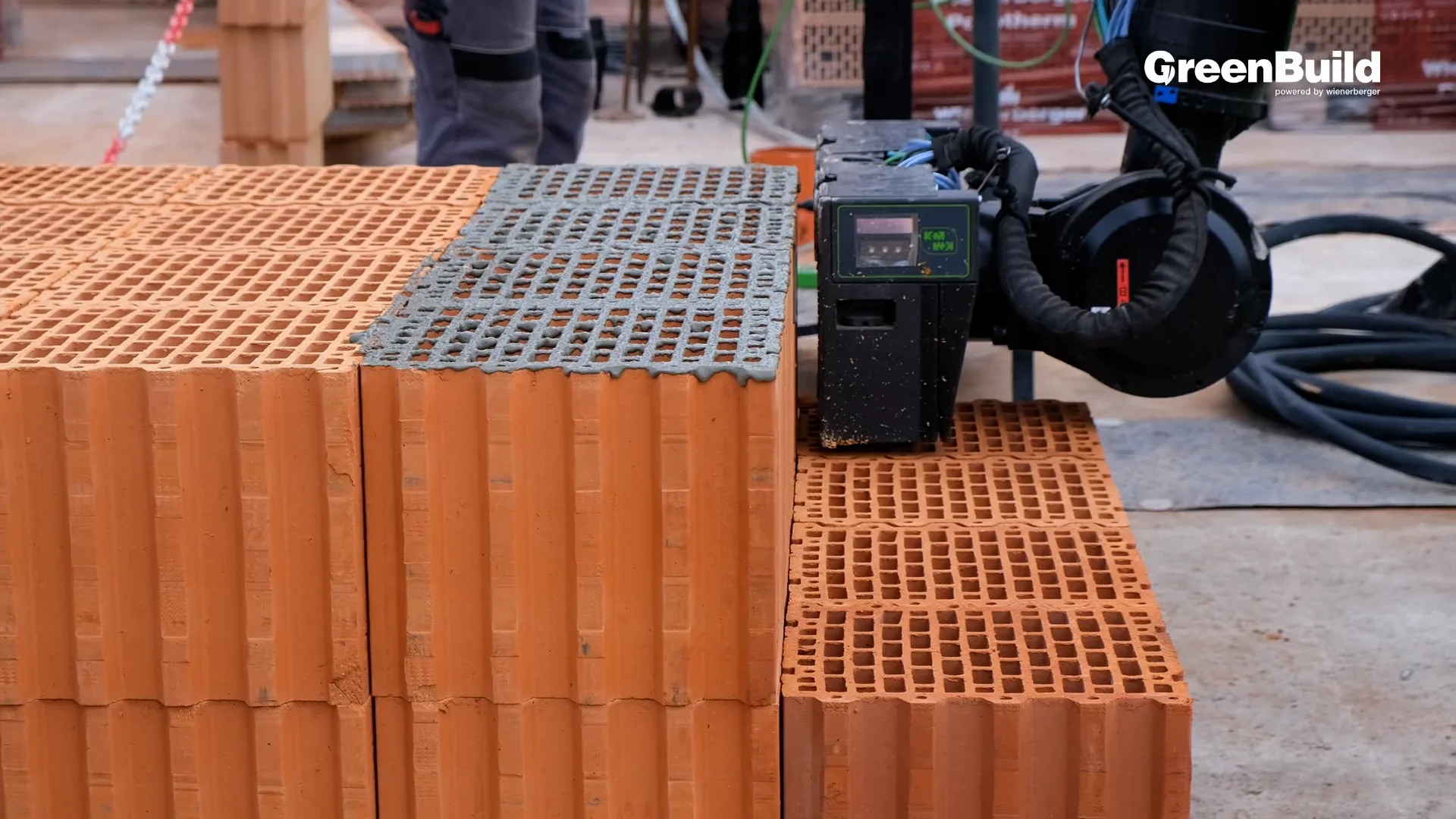

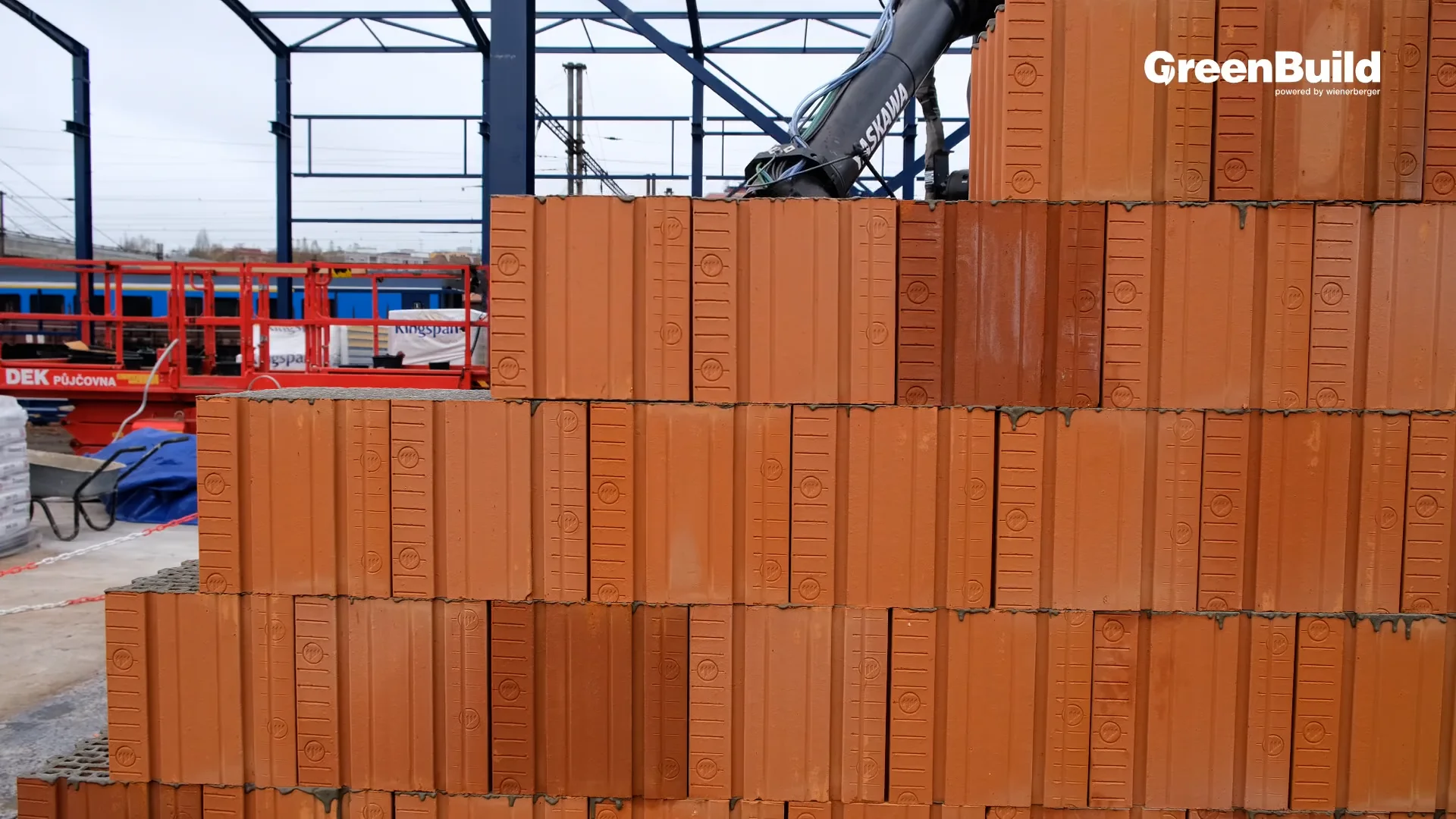

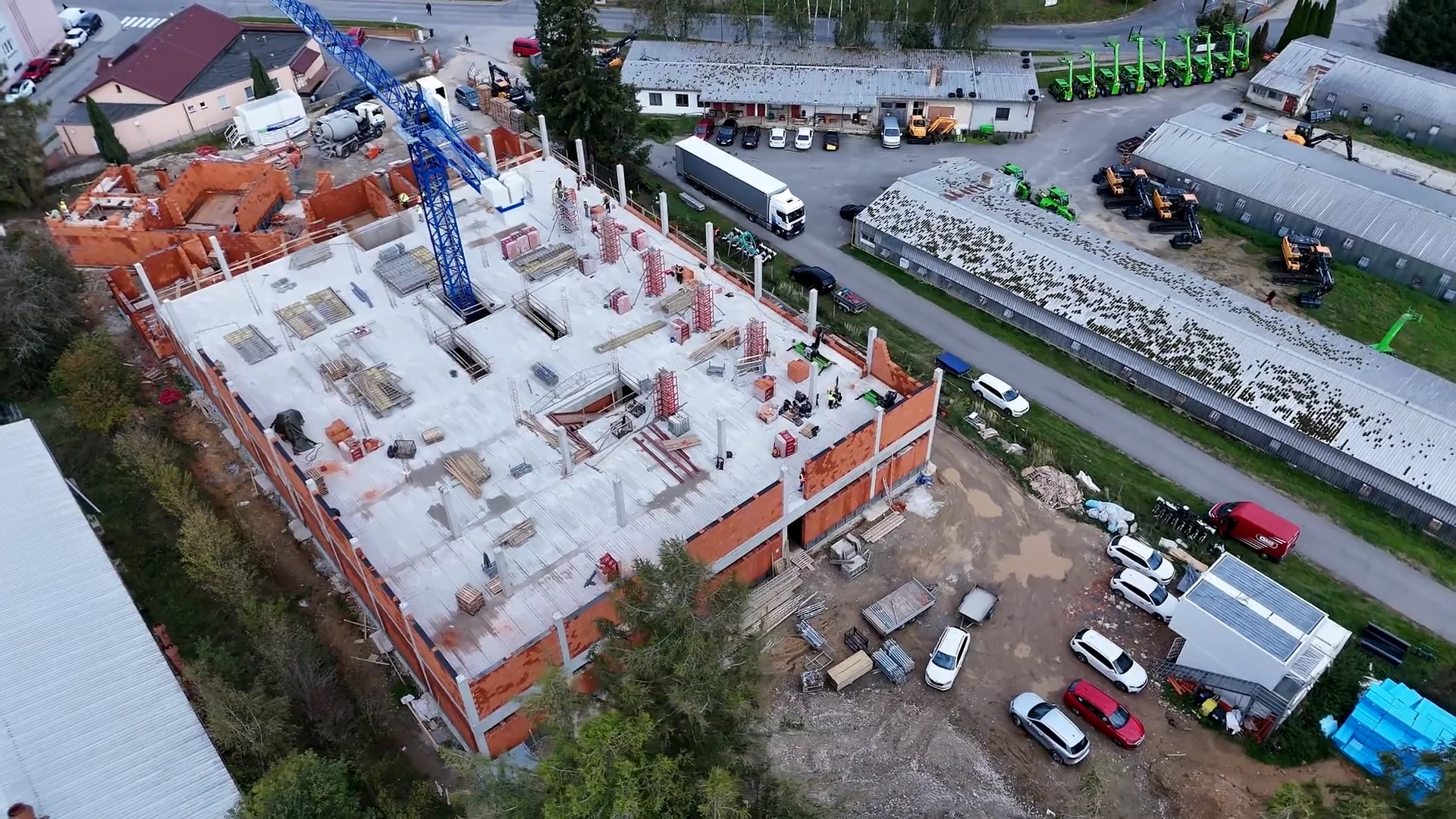

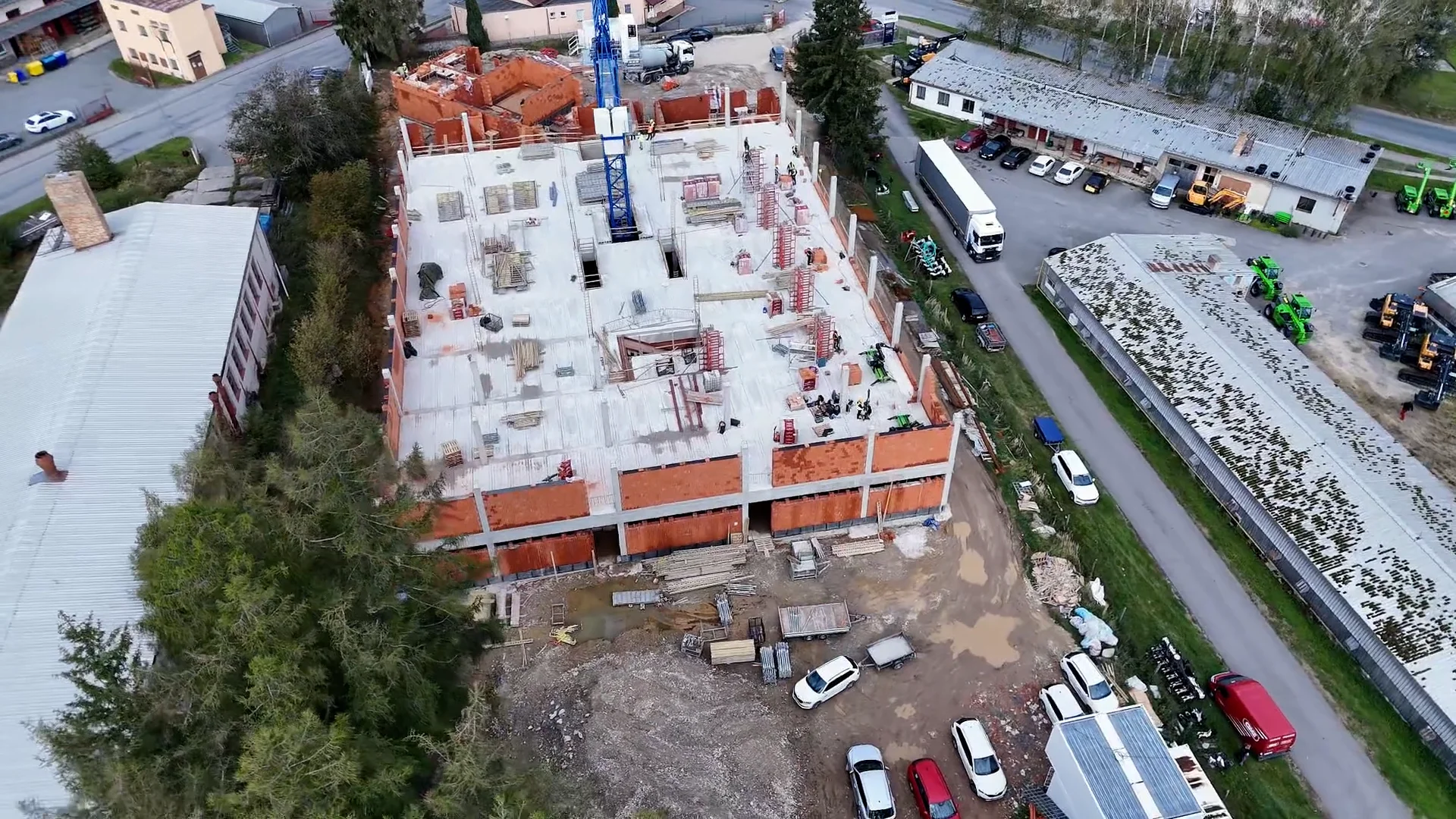

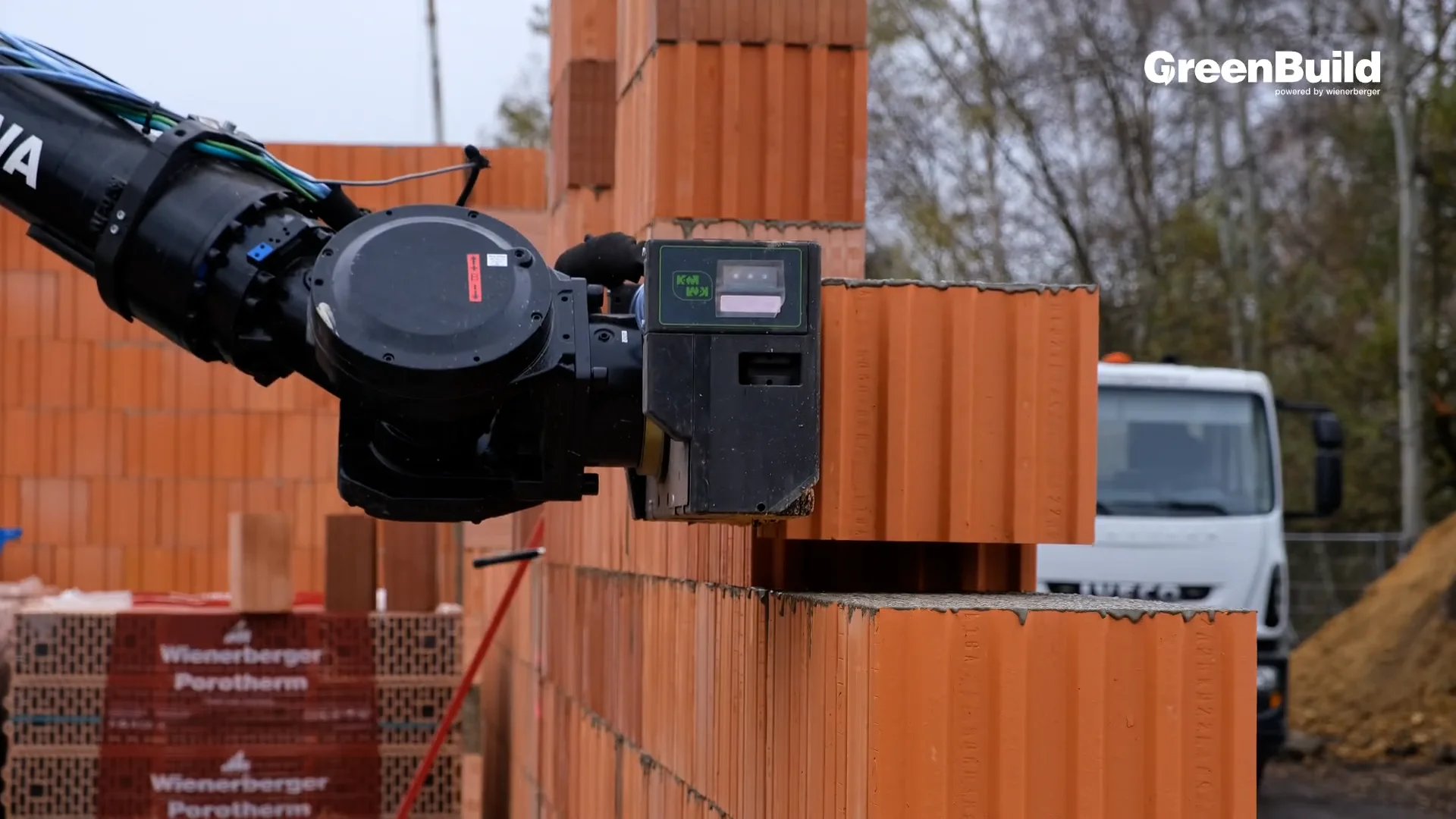

National Artefacts Depository in Pelhřimov, Czech Republic

WLTR makes history: In the Czech town of Pelhřimov, themasonry robot helped preserve the past by building for the future. On the construction site of a National Artefacts Depository, WLTR proved how efficient and reliable robotic construction can be, even on large-scale cultural infrastructure projects.

card iconcard icon
arrowcard icon

Location:

Pelhřimov, Czech Republic

Project:

National Artefacts Depository

Scope:

Complete delivery of masonry works

Masonry area:

1,873 m²

Total number of robots:

3 WLTR units

Average masonry speed:

5.9 m² per hour

Used Robot Ready material:

Porotherm 30 RR Profi P10

Used binder:

Porotherm Dryfix masonry foam

Duration:

10 weeks (instead of 14)

Train Station Repair Center in Cheb, Czech Republic
arrow

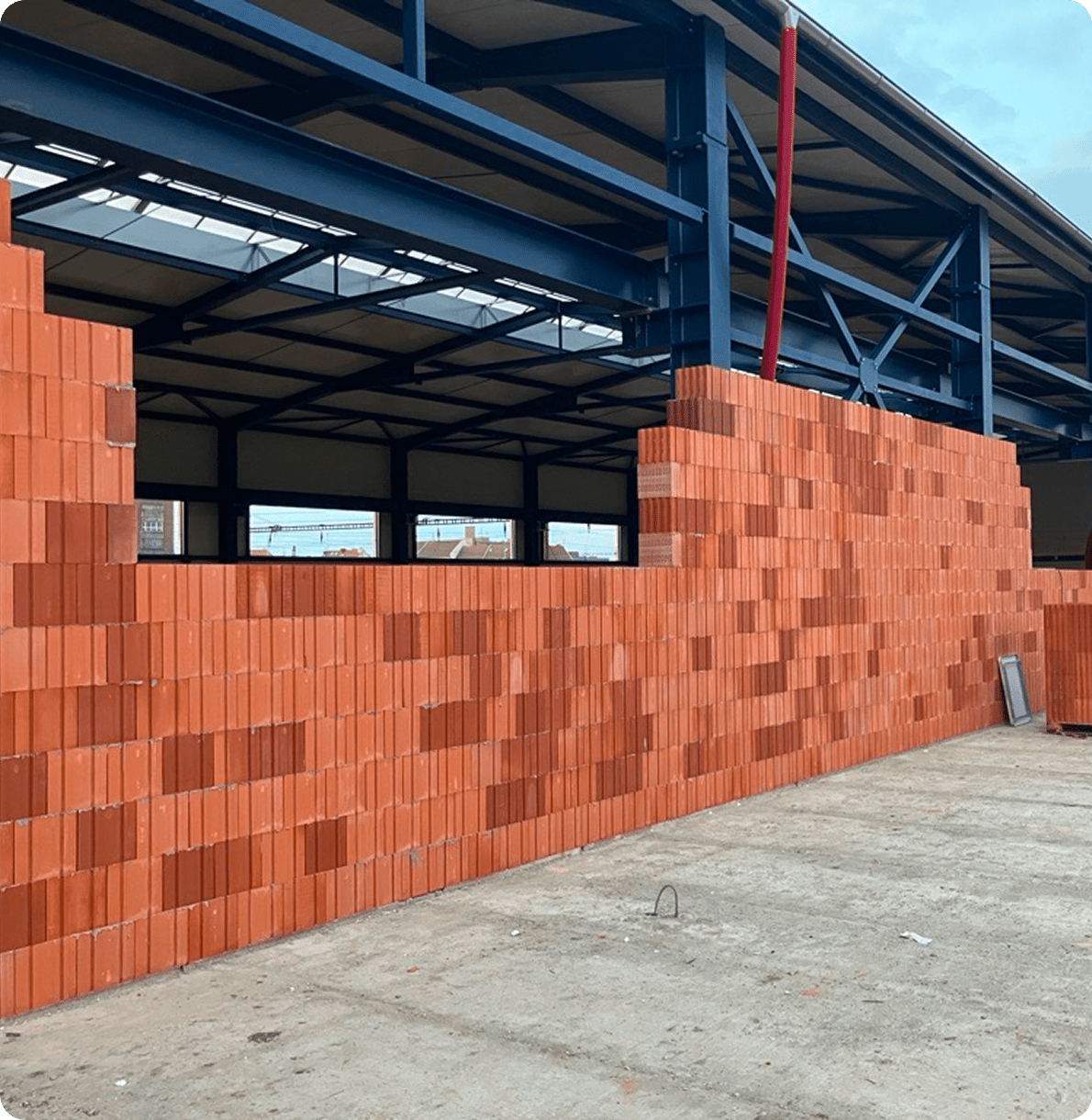

Next stop: Innovation. WLTR built a train station repair center. On behalf of the national train service, the masonry robot helped build the future of Czech infrastructure, brick by brick. At a repair center in Cheb, WLTR delivered high performance on an active transport project with national relevance.

card iconcard icon
arrowcard icon

Location:

Cheb, Czech Republic

Project:

Train station repair center

Scope:

Complete delivery of masonry works

Masonry area:

1,650 m²

Total number of robots:

2 WLTR units

Average masonry speed:

6.4 m² per hour per robot

Used Robot Ready material:

- PTH 30 RR P15 Profi
- Lintels

Used binder:

Not specified

Duration:

4 weeks

Aloys Klar Kindergarten in Prague, Czech Republic
arrow

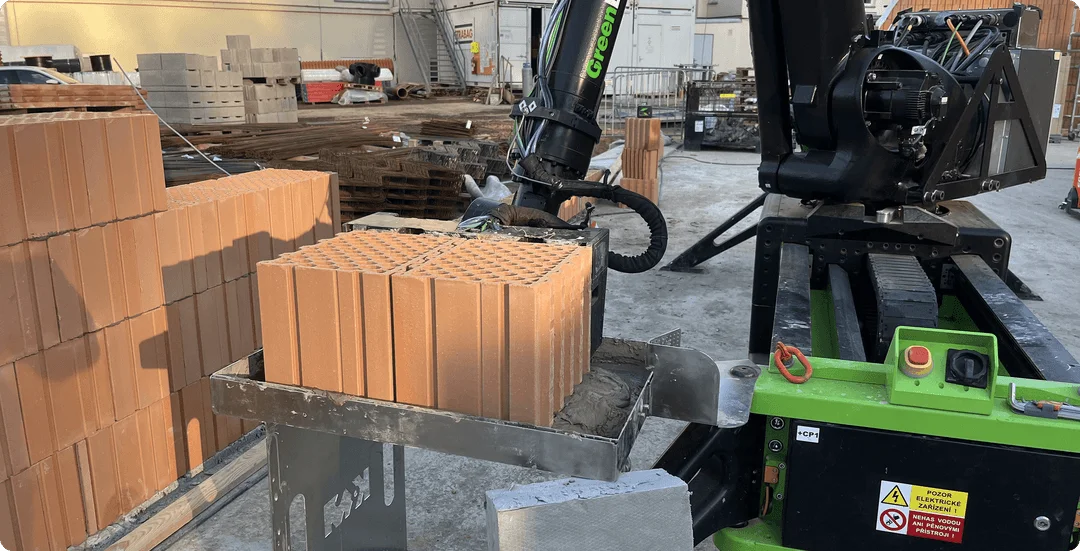

Child’s Play for WLTR: He proves its capabilities under real construction site conditions. In the Czech capital, anew kindergarten building was completed together with STRABAG in just 5 weeks, covering a total of 1,454 m² of masonry fully automated using two WLTR units.

card iconcard icon
arrowcard icon

Location:

Prague, Czech Republic

Project:

Kindergarten

Scope:

Complete delivery of masonry works

Masonry area:

1,454 m²

Total number of robots:

2 working simultaneously

Average masonry speed:

7 m² per robot

Used Robot Ready material:

PTH 24 RR P15 Profi

Used binder:

Porotherm Profi thin-bed mortar

Duration:

5 weeks (instead of 6)

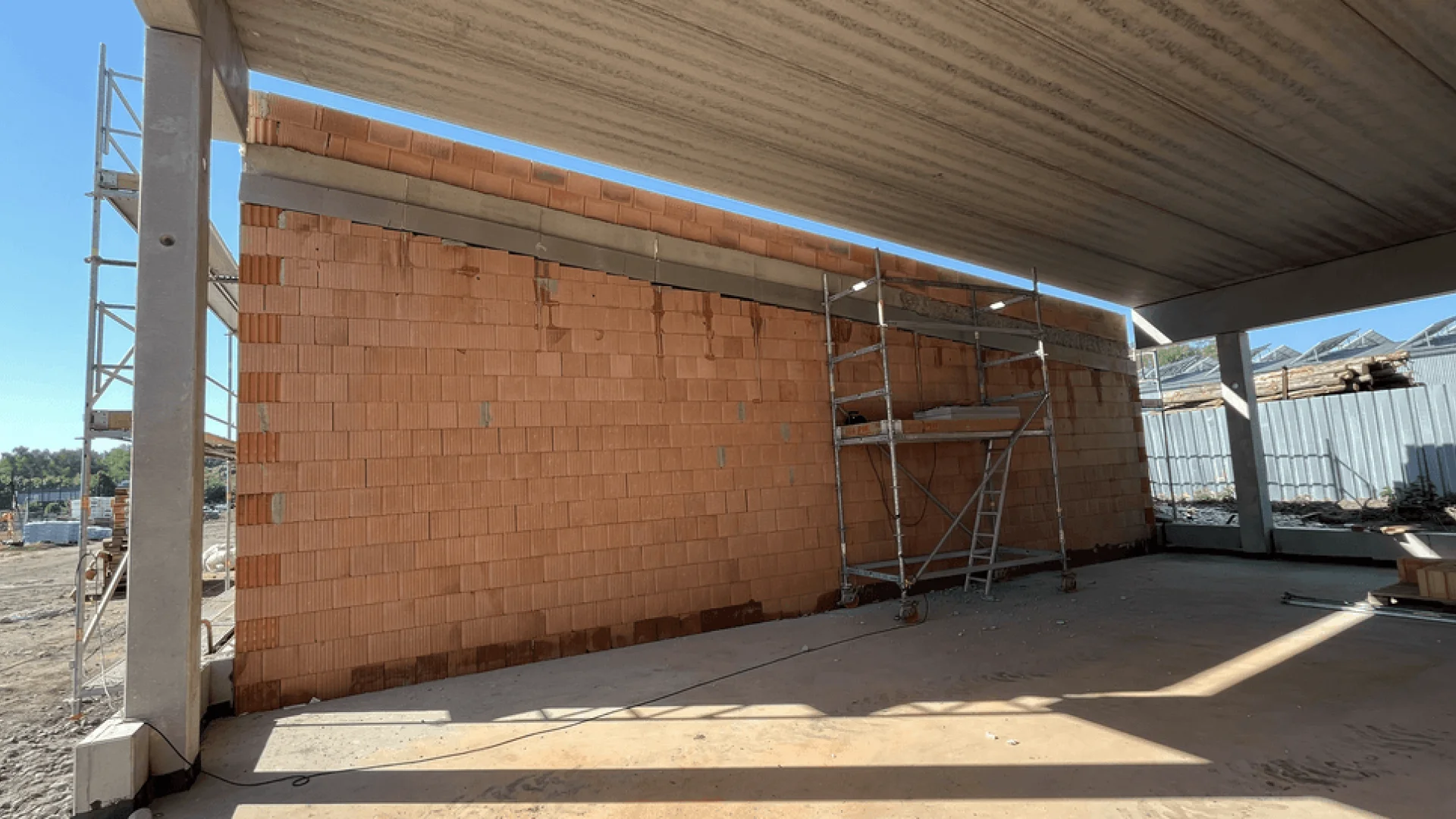

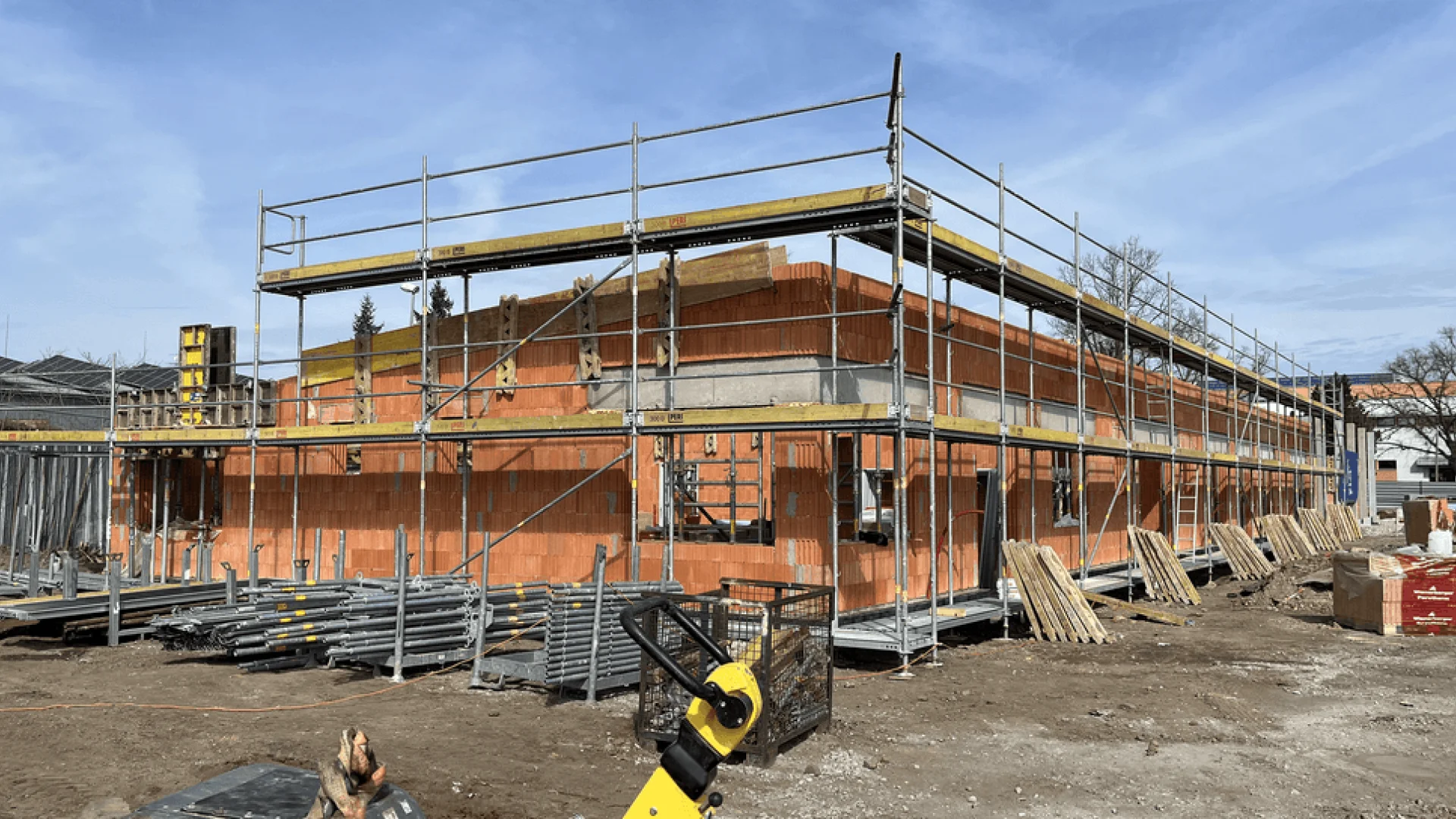

Sports Complex in České Budějovice, Czech Republic
arrow

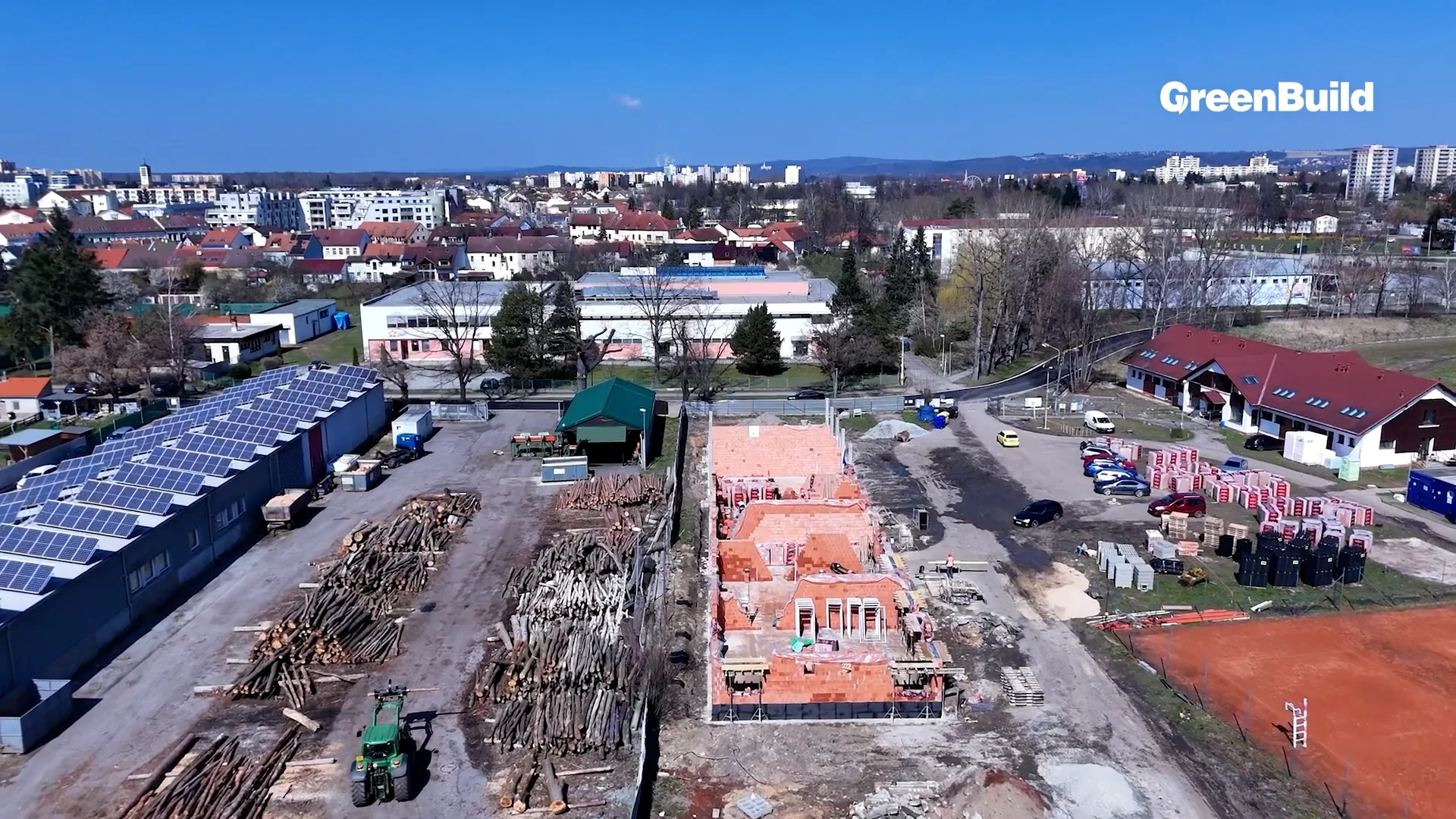

WLTR hit peak performance and built at record speed:In just 2 weeks, a sports complex with almost 700 m² of masonry was builtin České Budějovice as part of the University of South Bohemia extension, fullyautomated by two WLTR units and using three different types of bricks,including acoustic bricks.

card iconcard icon
arrowcard icon

Location:

České Budějovice, Czech Republic

Project:

Sports Complex

Scope:

Complete delivery of masonry works

Masonry area:

693 m2

Total number of robots:

2 working simultaneously

Average masonry speed:

5 m² per robot

Used Robot Ready material:

- PTH 30 RR P10 Profi
- PTH 24 RR P15 Profi
- AKU PTH 19 RR P15 Profi (acoustic)

Used binder:

Porotherm Profi thin-bed mortar

Duration:

2 weeks (instead of 3)

Public facility building
arrow

Scope:

Complete delivery of masonry works

Masonry completed by robots:

1,069 m2

Total number of robots:

1 working independently

Average masonry speed:

5,2 m2/h

Used Robot Ready material:

Porotherm 30 RR Profi

Used binder:

Porotherm Profi thin-layer masonry mortar

Kindergarten and Nursery in Koronowo, Poland
arrow

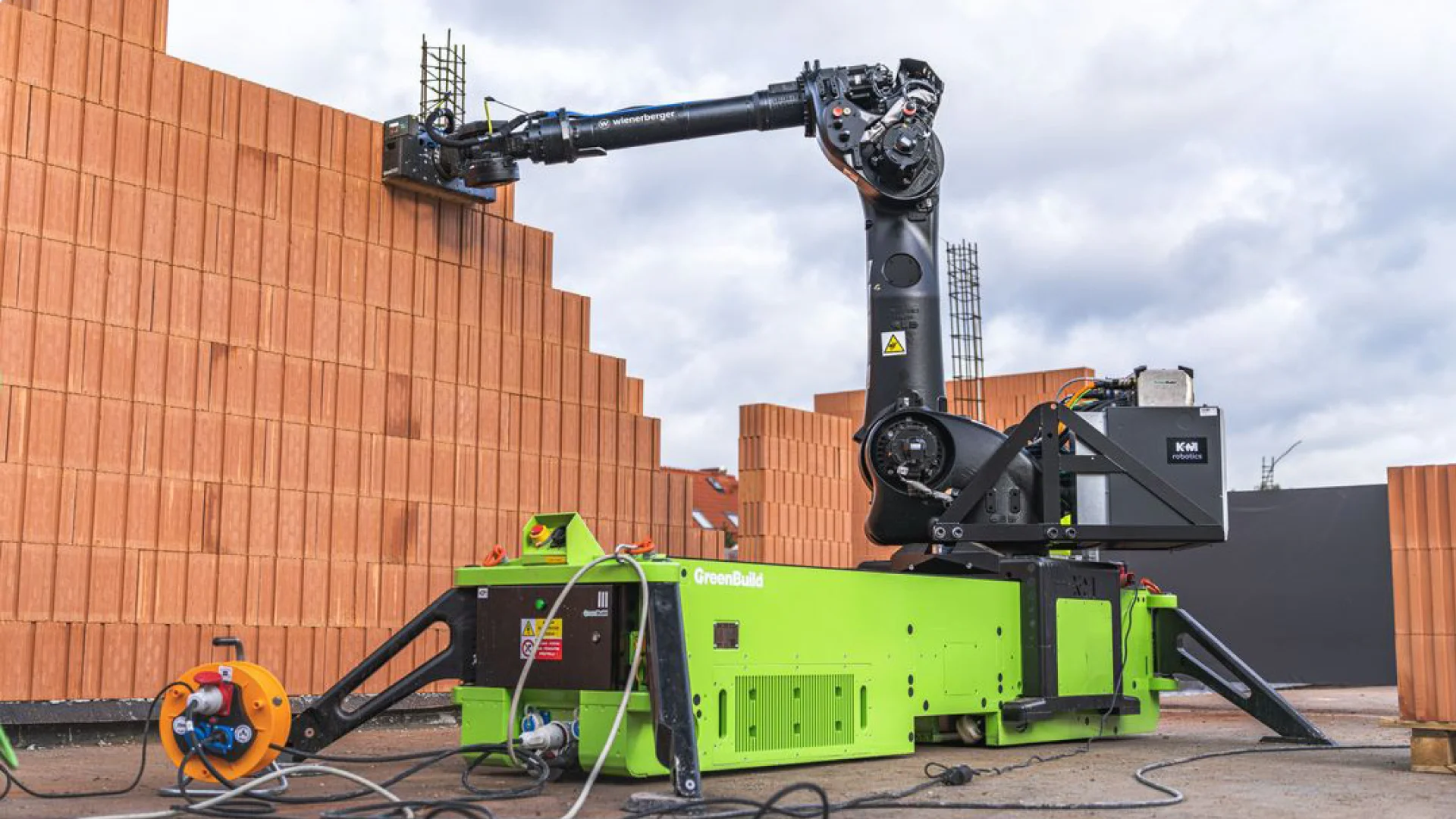

WLTR’s latest playground: In Koronowo, a new chapterin Polish construction has begun and the masonry robot was first on site. Together with Wienerberger Polska, masonry walls for a public kindergarten and nursery for over 170 children were built. All in just 8 days.

card iconcard icon
arrowcard icon

Location:

Koronowo, Poland

Project:

Kindergarten and nursery for 170+ children

Scope:

Complete delivery of masonry works

Masonry area:

600 m²

Total number of robots:

2 working simultaneously

Average masonry speed:

37.5 m² per robot per day

Used Robot Ready material:

Porotherm 25 500 RR Dryfix

Used binder:

Porotherm Dryfix

Duration:

8 days (instead of over 2 weeks)

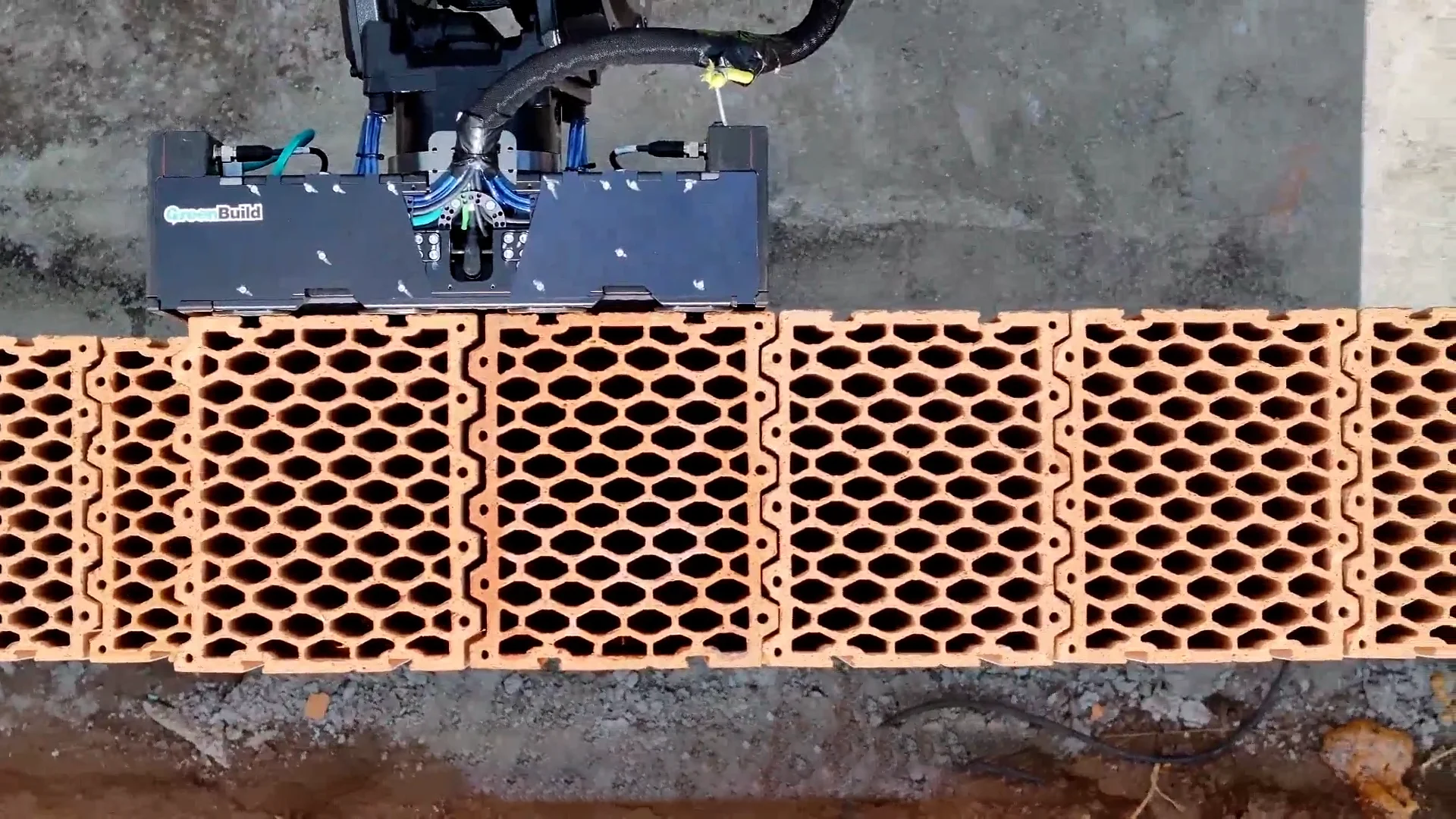

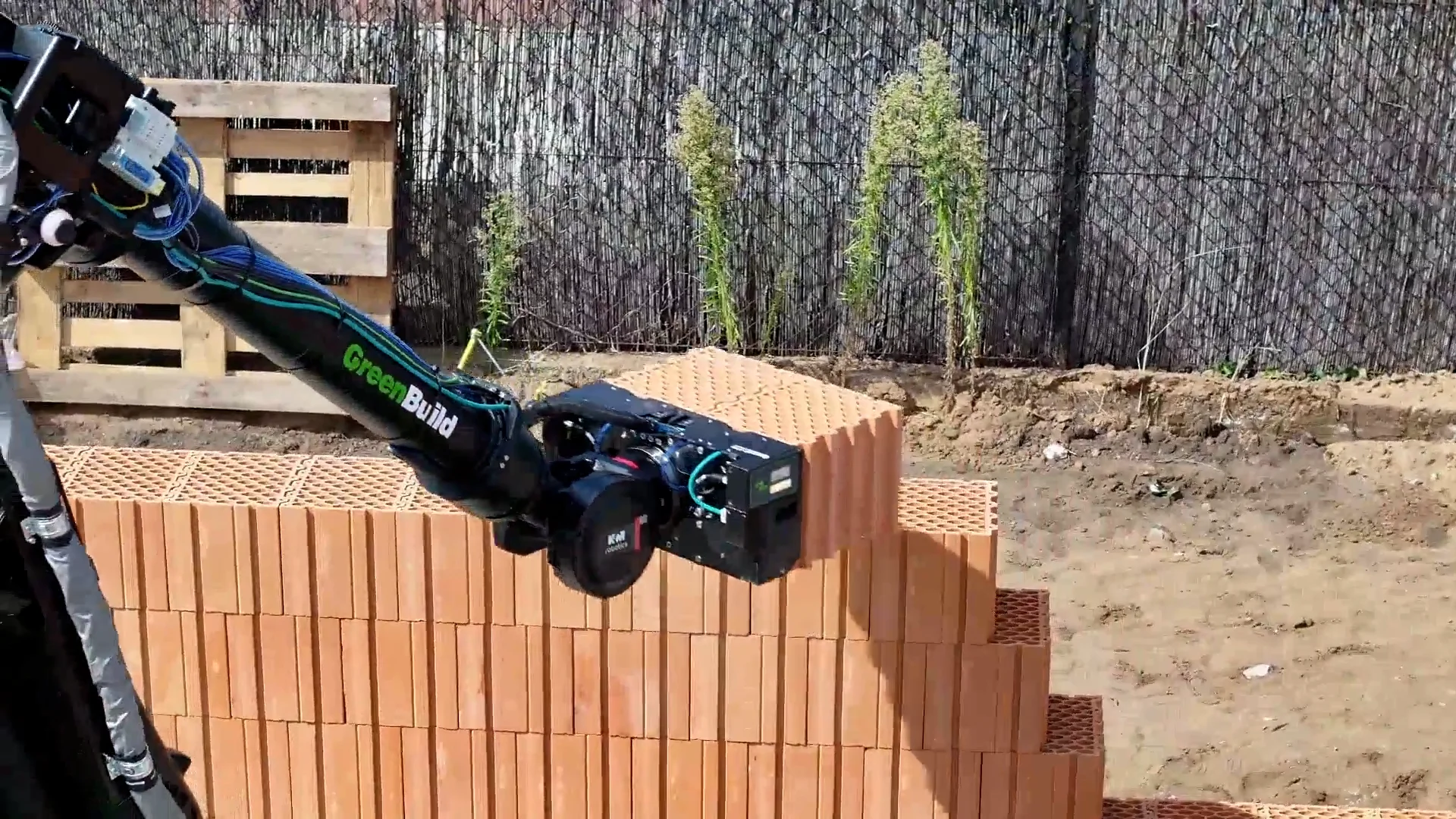

Single-Family Home in Budapest, Hungary
arrow

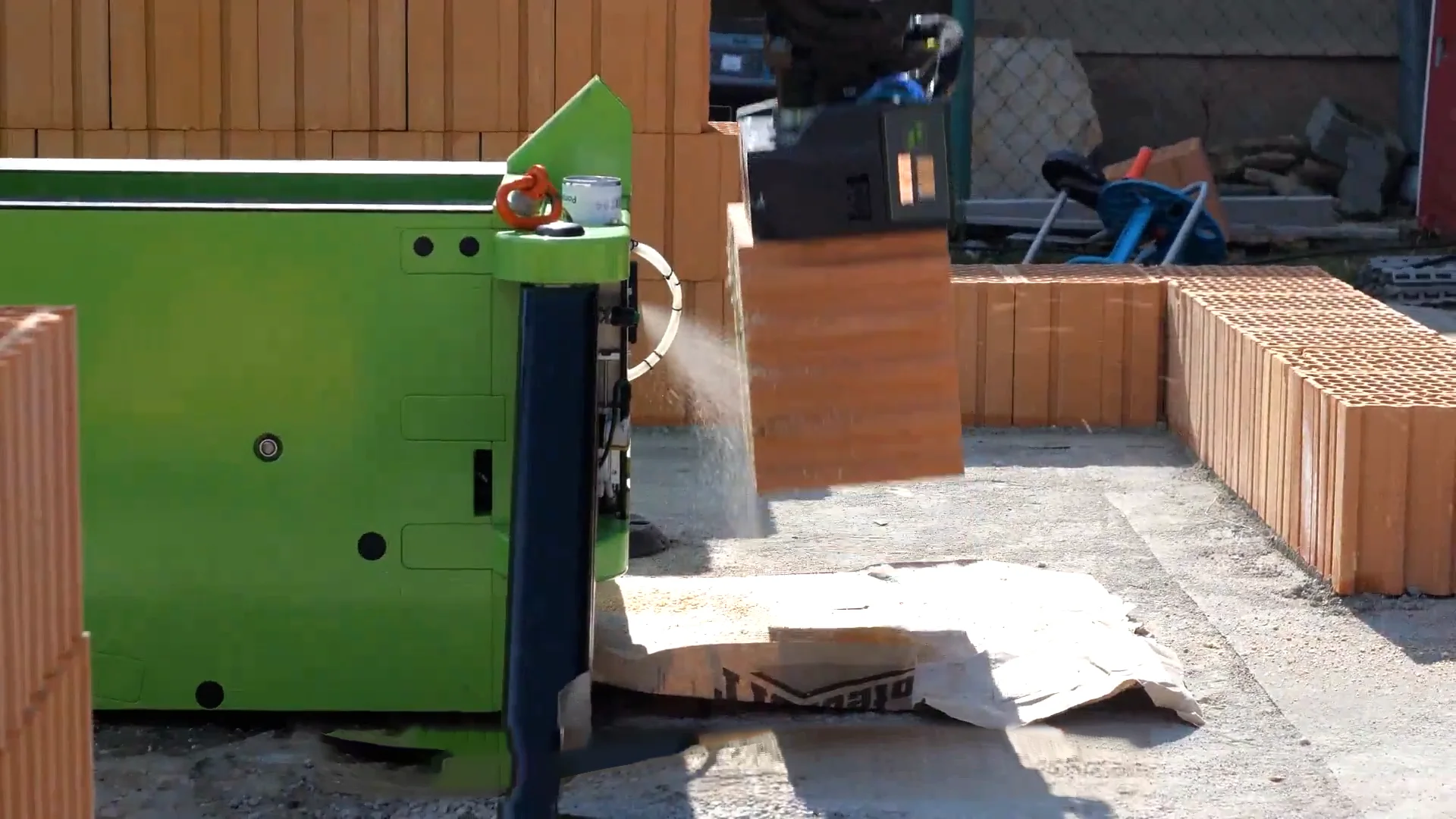

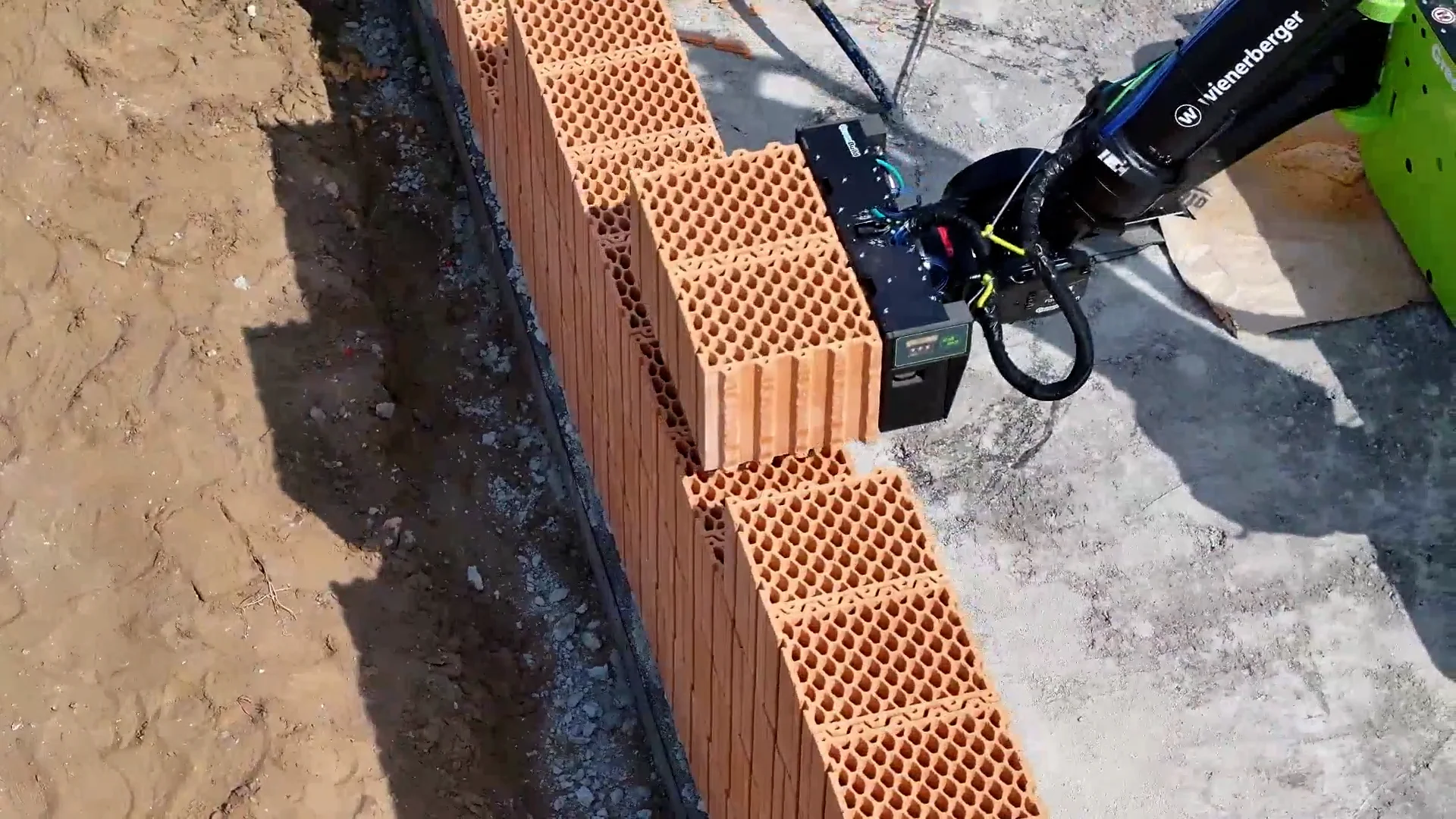

Homemade by WLTR: First house built in Hungary in just three days. In Budapest’s 18th district, a pioneering masonry project was delivered together with Wienerberger Magyarország and local construction partner Berill Házépítő Kft., fully automated by one WLTR unit.

card iconcard icon
arrowcard icon

Location:

Budapest, District 18, Hungary

Project:

Single-family home

Scope:

Complete delivery of masonry works

Total number of robots:

1 working unit

Average masonry speed:

up to 10 m² per hour

Used Robot Ready material:

- Porotherm 30 RR Profi
- Porotherm 19 RR AKU Profi

Used binder:

Porotherm Dryfix

Duration:

3 days

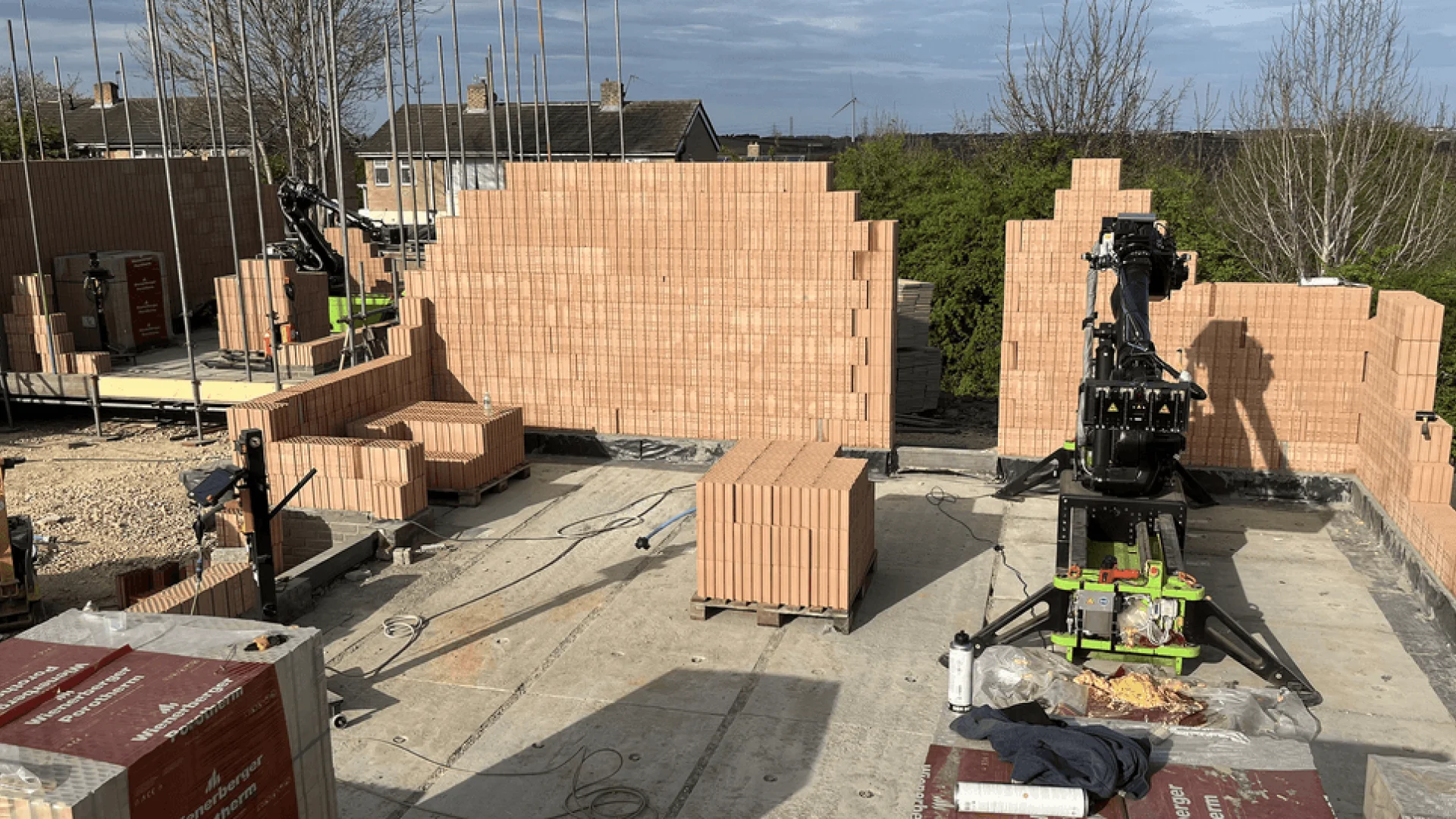

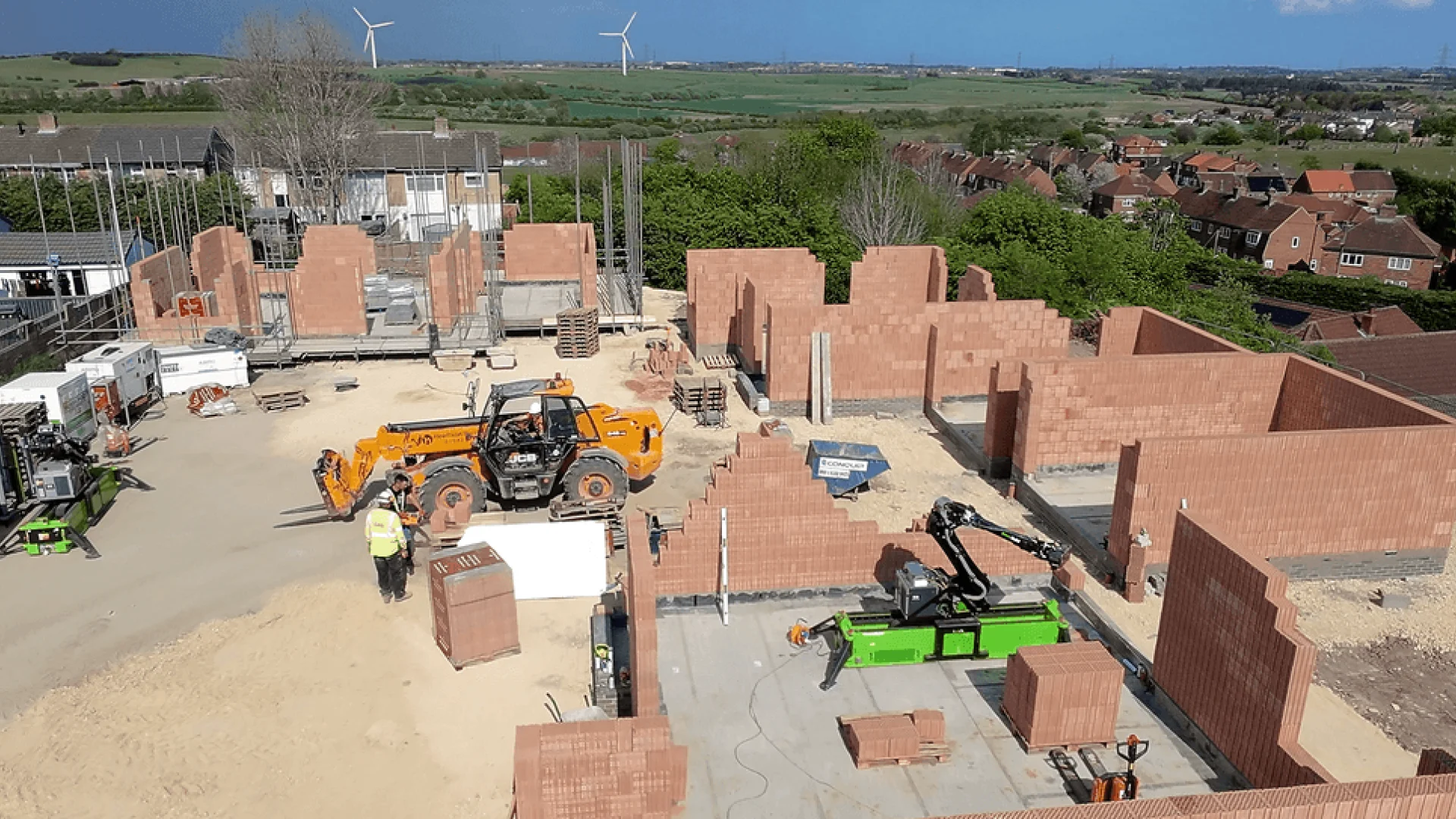

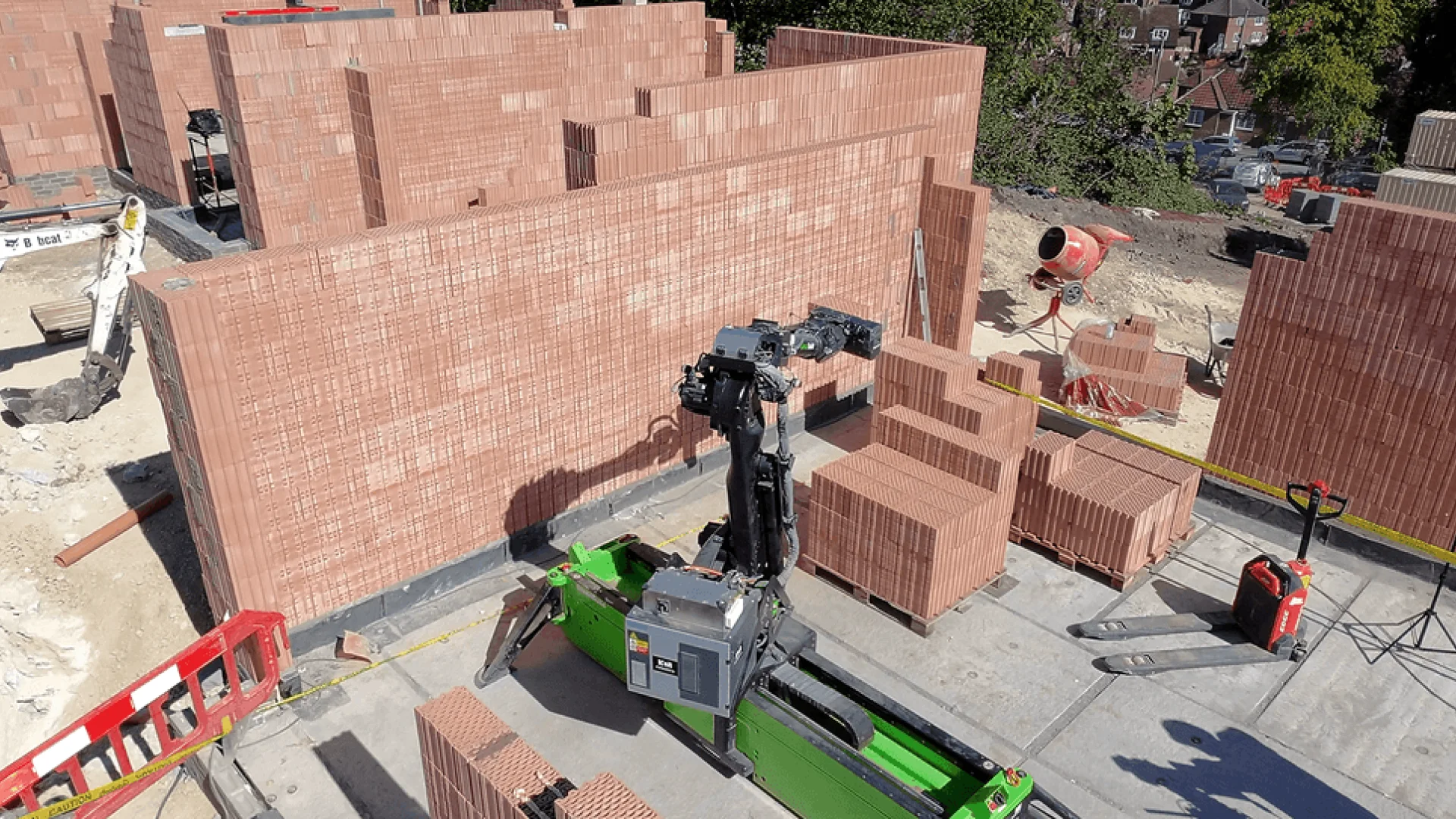

7 detached homes in Thornley, United Kingdom
arrow

Home Sweet Homes in Thornley: Built by robots, made for families. In Thornley near Durham, Maple Close, a street of seven modern, four-bedroom detached homes, was built together with JT Lifestyle Homes. The internal block work was completed by two WLTR units, fully automated and with machine precision.

card iconcard icon
arrowcard icon

Location:

Thornley, United Kingdom

Project:

Maple Close – 7 detached homes

Scope:

Complete delivery of masonry works

Masonry area:

1,310 m²

Total number of robots:

2 working simultaneously

Average masonry speed:

5.6 m² per robot

Used Robot Ready material:

Porotherm 24 RR Profi

Used binder:

Porotherm Dryfix masonry foam

Duration:

7 weeks

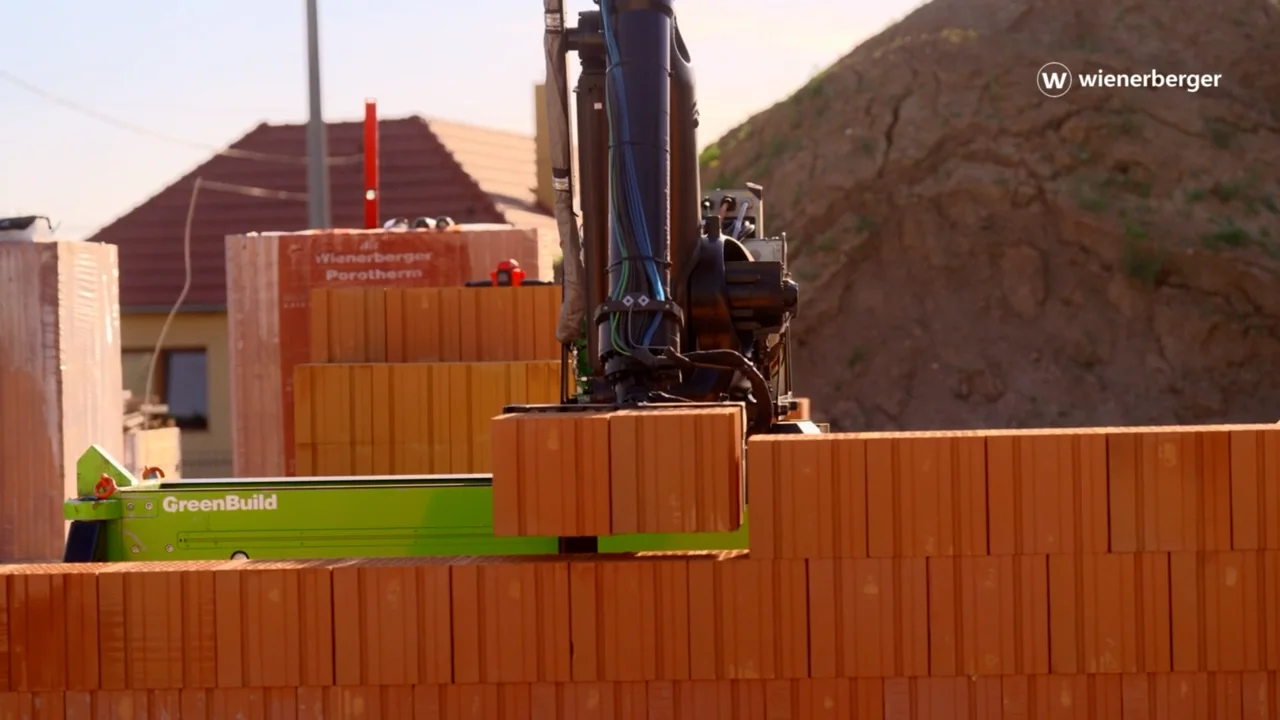

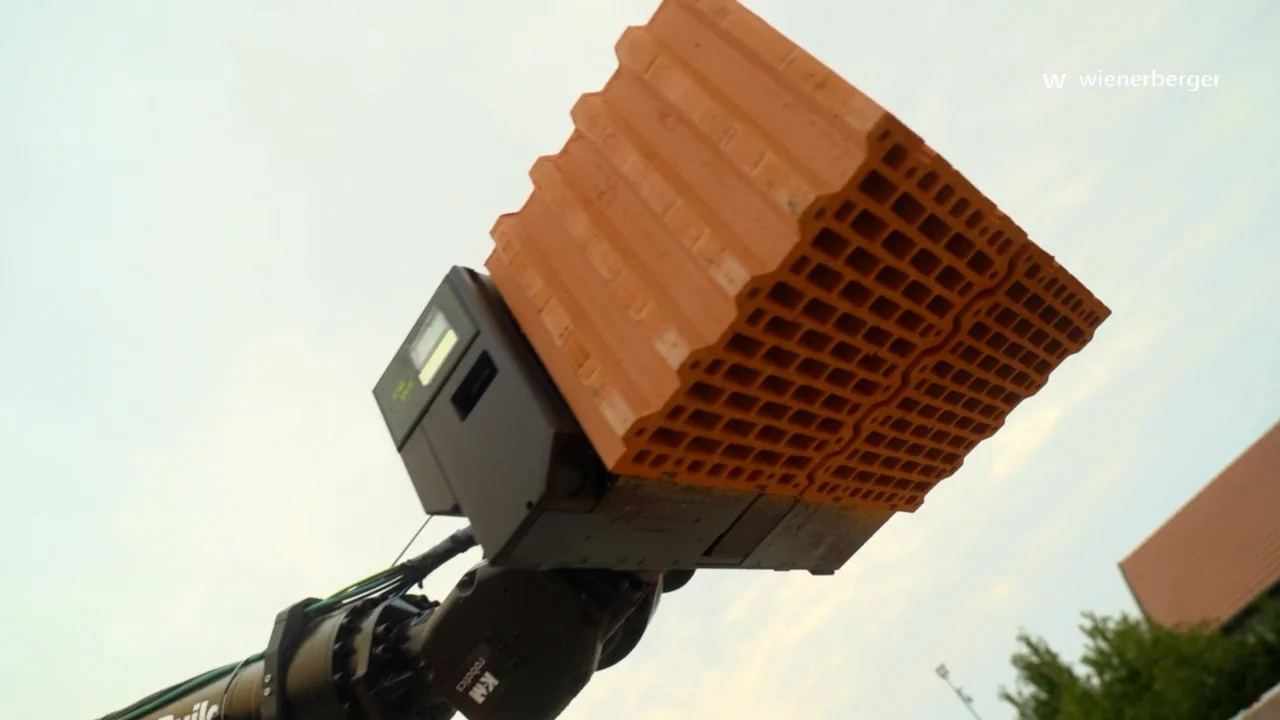

Single-Family House in Martin nadŽitavou, Slovakia
arrow

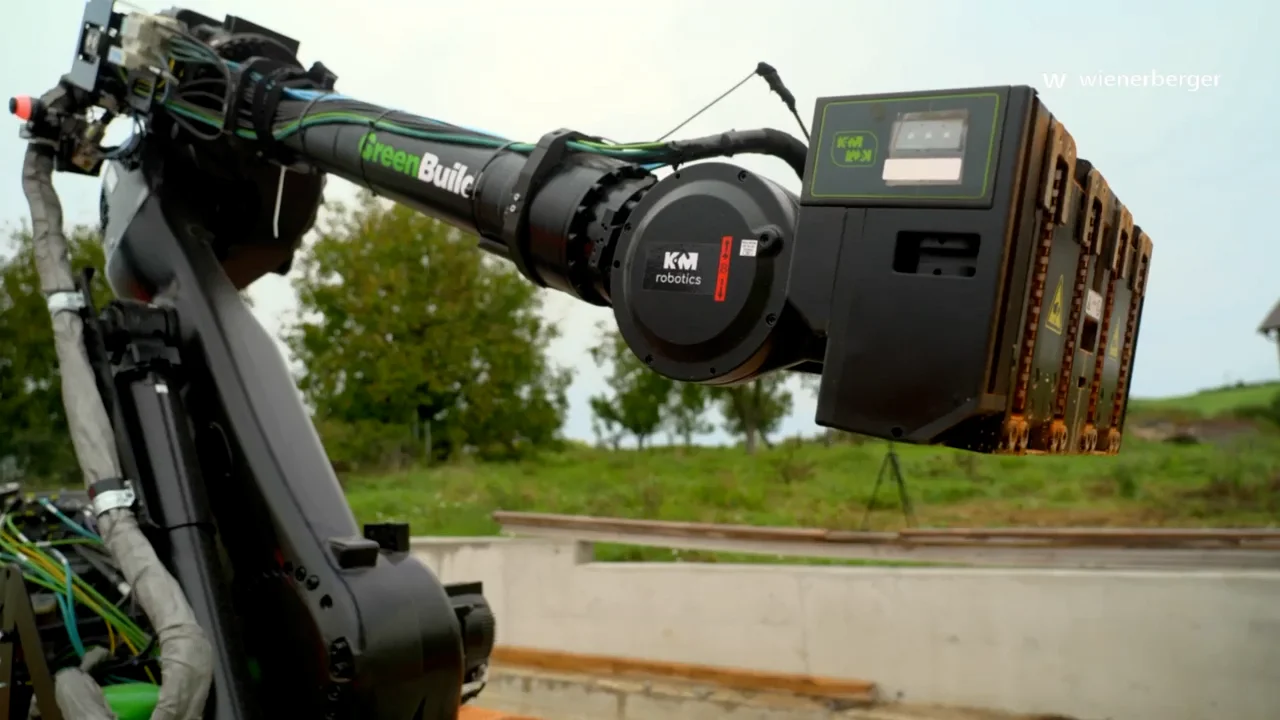

WLTR feels perfectly at home building family houses: In Martin nad Žitavou, the masonry robot made its Slovak debut and was building like it had always been part of the family. On the construction site of a single-family house in the Nitra region, WLTR showed how efficient, precise and reliable modern brickwork can be.

card iconcard icon
arrowcard icon

Location:

Martin nad Žitavou, Slovakia

Project:

Single-family house

Scope:

Complete delivery of masonry works

Masonry area:

237 m²

Total number of robots:

1 working unit

Average masonry speed:

5 m² per hour per robot

Used Robot Ready material:

Porotherm 30 RR Profi

Used binder:

Porotherm Dryfix masonry foam

Duration:

2 weeks
